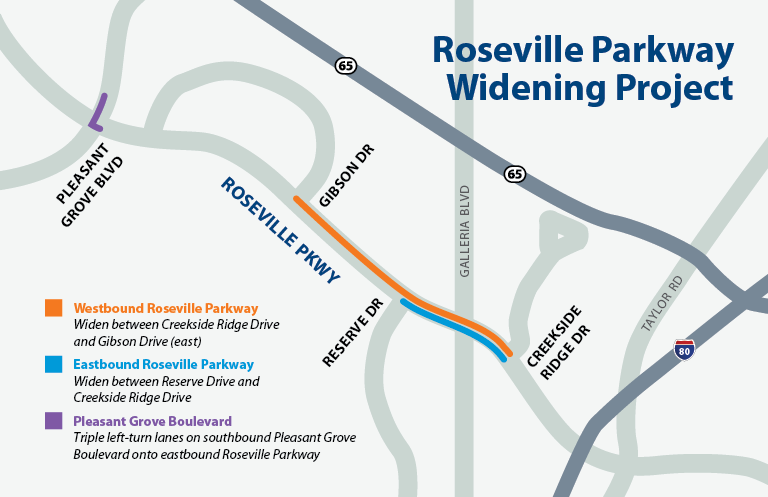

Design is underway on a planned project to widen Roseville Parkway, between Gibson Drive and Creekside Ridge Drive intersections. Roadway improvements at the Pleasant Grove Boulevard intersection are also included.
Future roadway widening in this area was identified in the 2035 General Plan. This project is constructing these planned improvements. It also reflects Roseville’s planning approach, where infrastructure needs are identified and delivered in phases as the community grows.
This six-lane arterial roadway links regional shopping and dining destinations, office buildings, and residential neighborhoods.
The project will be constructed in two phases and is part of the City Council-approved Capital Improvement Plan.
Phase 1:
Much of the widening will be accomplished by converting the current auxiliary lanes to through lanes.
Future roadway widening in this area was identified in the 2035 General Plan. This project is constructing these planned improvements. It also reflects Roseville’s planning approach, where infrastructure needs are identified and delivered in phases as the community grows.
This six-lane arterial roadway links regional shopping and dining destinations, office buildings, and residential neighborhoods.
The project will be constructed in two phases and is part of the City Council-approved Capital Improvement Plan.
Phase 1:
- Adding a third left-turn lane on southbound Pleasant Grove Boulevard onto eastbound Roseville Parkway.
- Extending the right turn lane on northbound Pleasant Grove Blvd to eastbound Roseville Parkway.
- Creating a bus turnout for the existing transit stop on westbound Roseville Parkway between West Drive and Reserve Drive.
- Constructing intersection improvements at Roseville Parkway and Galleria Boulevard
- Adding a third left-turn lane from northbound Galleria onto westbound Roseville Parkway
- Extending the length of the eastbound left-turn lanes onto northbound Galleria Boulevard
- Extending the length of the westbound right-turn lane onto northbound Galleria Boulevard
Much of the widening will be accomplished by converting the current auxiliary lanes to through lanes.
- Constructing remaining infrastructure to widen Roseville Parkway from 3 lanes to 4 lanes in each direction from Creekside Ridge Drive to the eastern end of Gibson Drive.
- The westbound direction will be widened between Creekside Ridge Drive and Gibson Drive (east).
- The eastbound direction will be widened between Reserve Drive and Creekside Ridge Drive.
- Intersection improvements including modifications to existing traffic signals.
- Construction of new lanes, sidewalks, curbs and gutters where necessary.
- Updated signage and pavement striping along the project route.
- Necessary utility adjustments
The project is currently in the design phase.
Stakeholder engagement began in summer 2022.
Construction estimated to occur in two phases.
Timeline is approximate and subject to change
Stakeholder engagement began in summer 2022.
Construction estimated to occur in two phases.
- Phase 1: Work anticipated summer 2026 - early 2027
- Phase 2: When adequate funding is identified, which could be as soon as 2028-29.
Timeline is approximate and subject to change
The Initial Study/Mitigated Negative Declaration were available for public review and comment from March 8 to April 8, 2024 (30 days).
- Final Notice of Intent to adopt Mitigated Negative Declaration
- Roseville Parkway Widening Project Initial Study/Mitigated Negative Declaration
Documents can be viewed in person by appointment, at the City of Roseville Permit Center, 311 Vernon Street, Roseville, CA 95678. To schedule an appointment online: roseville.ca.us/DS-appointment or call (916) 774-5285.
Written comments on the adequacy of the Mitigated Negative Declaration were due by 5:00 p.m. on April 8, 2024. During the public review period written comments were to be provided to:
Jessica Lynch, Environmental Coordinator
City of Roseville Development Services Department
311 Vernon Street
Roseville, CA 95678
(916) 774-5352
Email
A community open house was held:
September 20, 2022
6 – 7:30 p.m.
Catheryn Gates Elementary
1051 Trehowell Dr.
View a summary.
Contact Public Works with any project inquiries:
Email
(916) 746-1300
September 20, 2022
6 – 7:30 p.m.
Catheryn Gates Elementary
1051 Trehowell Dr.
View a summary.
Contact Public Works with any project inquiries:
(916) 746-1300
Design
Funding for the design phase is provided by developer-paid Traffic Mitigation Fees. These fees are gradually collected as development occurs and help the City to construct transportation projects identified in the Capital Improvement Program. Improvements address anticipated traffic impacts from new and existing development projects.
Learn more about how Roseville plans for growth and development: roseville.ca.gov/DevelopmentDecoded.
Construction
Phase 1 construction is anticipated to be approximately $6 million and is fully funded through a combination Community Facilities District funding and developer-paid Traffic Mitigation Fees.
Phase 2 construction is anticipated to be approximately $12 million. The City is pursuing funding opportunities, including state and federal grants.
